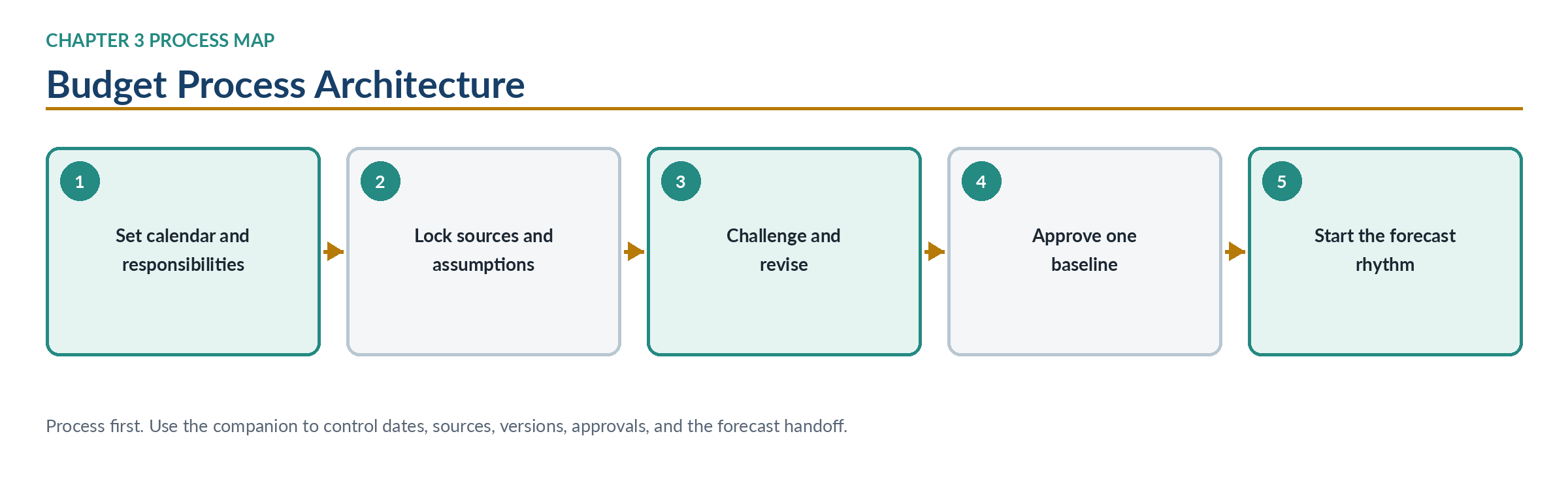

Chapter 3Budget Process Architecture
Turn the budget architecture into a controlled annual workflow with a calendar, source lock, ownership, revision gates, approval discipline, version control, and forecast handoff.
Questions this chapter helps answer
- When should a hotel start its annual budget process and what outputs should each review stage produce?
- How should responsibility, source lock, version control, challenge, owner review, and approval be governed during hotel budgeting?
- How does an approved hotel budget become a protected baseline and then hand off into the rolling forecast process?
Key concepts
- budget calendar
- responsibility matrix
- source lock
- version control
- department build
- finance consolidation
- GM challenge
- owner review
- approved baseline
- forecast handoff
When to Start, Who Owns What, and How the Budget Becomes a Forecast
This chapter converts the budget architecture into a controlled annual workflow. It explains when to start, what must be locked at each stage, how draft versions improve, who approves changes, and how the approved budget becomes the benchmark for forecasting.
EXECUTIVE TAKEAWAY
A hotel budget is a workflow before it is a spreadsheet. Strong processes start early enough to research, late enough to use meaningful evidence, and visibly enough to revise without losing control. The practical discipline is to start early enough for controlled review—often three to four months before the period—lock sources, assign owners, record assumptions, protect versions, and hand the approved baseline into a forecast rhythm.
Learning outcomes
• Build a budget calendar suited to the property, ownership structure, reporting year, and approval route.
• Use a three-to-four-month planning window without treating the earliest draft as final truth.
• Apply five controlled passes from orientation through the approved baseline.
• Use source locks, assumption logs, and version registers to prevent rework, silent change, and data conflict.
• Connect annual budgeting to monthly near-term, event-triggered, and quarterly full-year forecasting.
New in this chapter: budget calendar, source lock, 9+3 / 10+2 / 11+1, assumption log, version register, approval condition, and approved baseline. Full definitions belong in the Master Glossary.
BOUNDARY NOTE
This chapter does not teach rooms mechanics, labour formulas, capex prioritisation, or cash modelling. Those belong in the technical chapters. It establishes the process controls those chapters use. Chapter 4 applies them to rooms market research and revenue strategy.

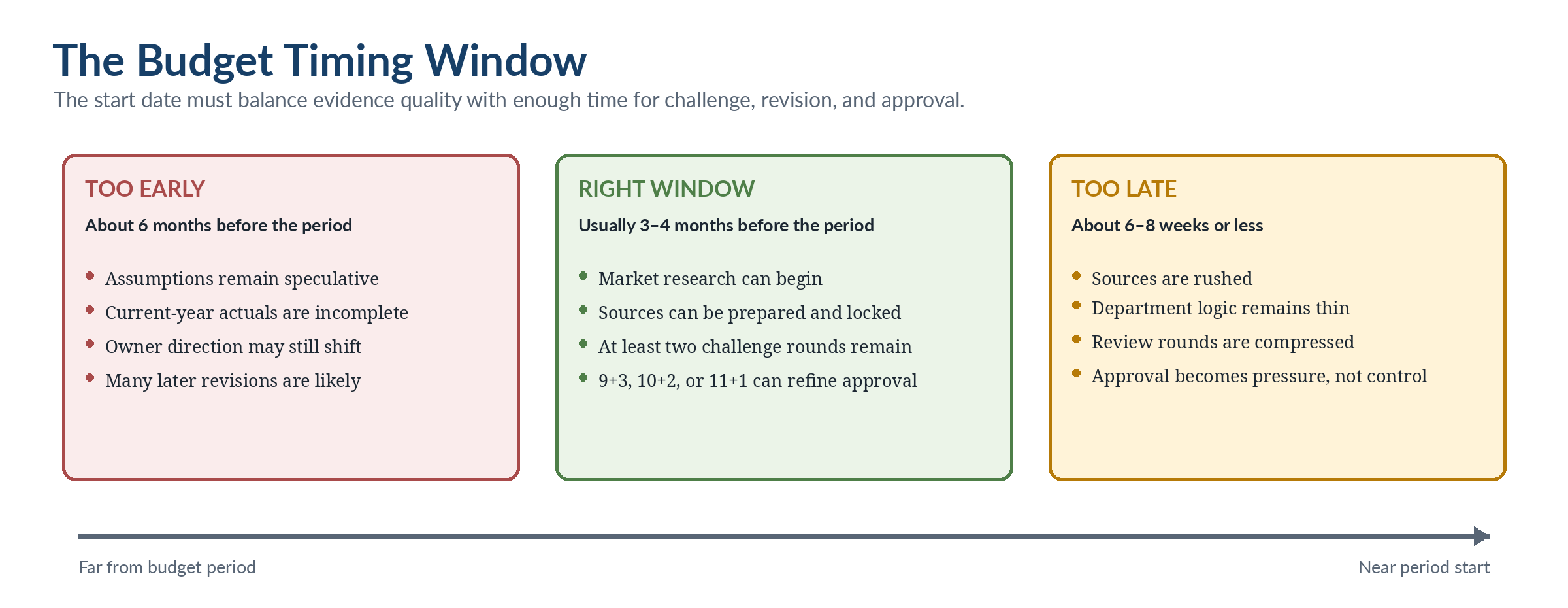

1. Timing is the first budget control
Budget season can fail before the first detailed schedule is built. The failure is often timing rather than formula logic.
Start too late and Finance requests inputs under year-end pressure. Department heads provide quick totals because there is no time to collect evidence, reconcile sources, or test operating handoffs. Review meetings then become negotiations about totals rather than management discussions about drivers and trade-offs.
Start too early and the process appears disciplined, but the assumptions are too distant from the budget period. The current year has not produced enough actual results, owner direction may still change, and market conditions may move. An early draft can orient the team; it should not be treated as the approved plan.
For many hotels, the workable starting point is three to four months before the budget period. The exact window may be longer for complex ownership, renovation, financing, or brand-approval processes and shorter for a small operation. The control principle is constant: preserve enough time for source preparation, a complete first draft, at least two challenge rounds, and stronger evidence before approval.
REALITY CHECK
The first draft is not supposed to be perfect. Its purpose is to expose assumptions, missing evidence, operating contradictions, and ownership gaps while there is still time to fix them.
2. Traditional versus controlled budget season
The same hotel can prepare a budget through two very different operating disciplines. The comparison below helps the team diagnose its current process before redesigning it.
Dimension | Traditional budget season | Controlled budget season |
|---|---|---|
Start | Six to eight weeks before year-end, usually under pressure. | Normally three to four months before the period, with planned review rounds. |
Initiation | Finance or owner direction triggers the exercise late. | The GM and Finance agree the calendar, source rules, responsibilities, and approval route. |
Department role | Departments provide totals after the structure is largely set. | Departments own operating assumptions before Finance consolidates them. |
Review pattern | One compressed review focused on totals. | Finance review, GM challenge, owner review, and controlled revision. |
Evidence quality | Current-year evidence is incomplete or used inconsistently. | Later versions incorporate stronger 9+3, 10+2, or 11+1 evidence where relevant. |
After approval | The budget becomes a static file. | The locked budget hands into monthly, event-triggered, and quarterly forecasting. |

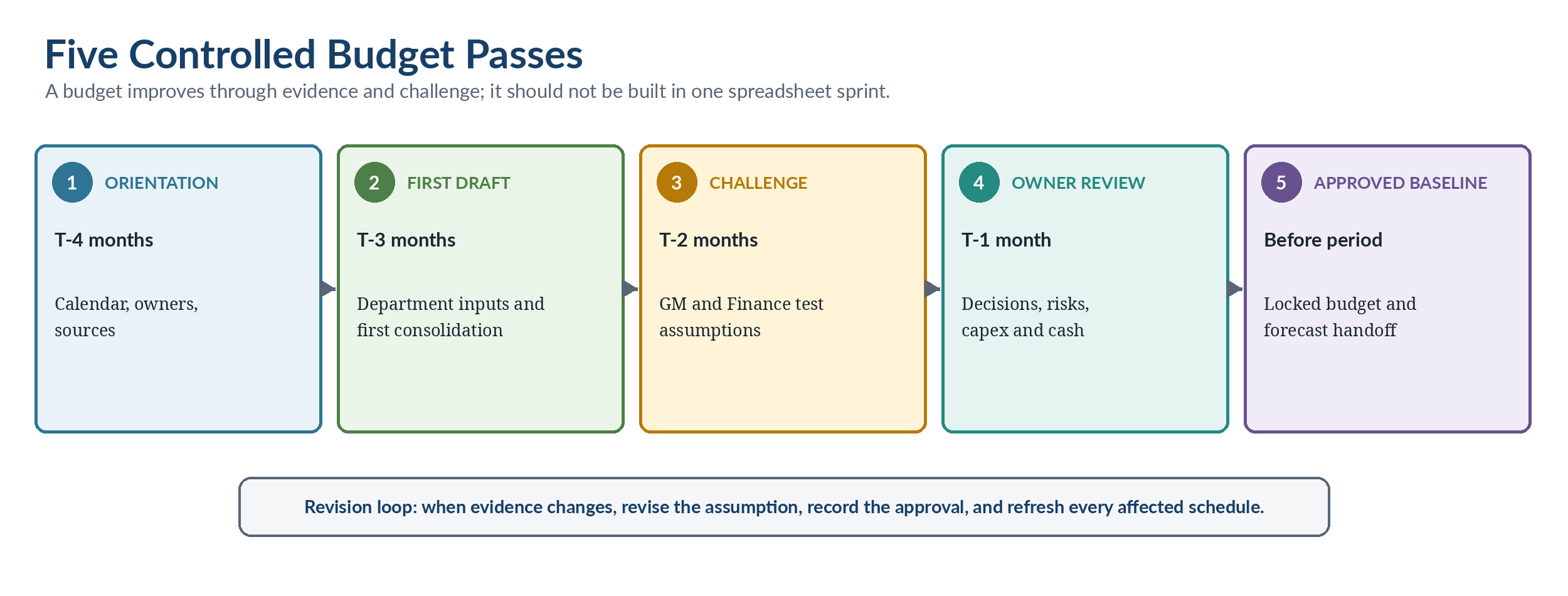

3. Build the budget in five controlled passes
A professional budget is not one file and one deadline. It is a sequence of controlled passes, each with a different purpose, output, and exit gate. A pass is complete only when its required control questions have been answered.
Pass | Timing | Primary owners | Required output | Exit gate |
|---|---|---|---|---|
1 — Orientation | T-4 months | GM + Finance | Budget calendar, responsibility map, owner requirements, source list, environment scan. | Dates, owners, source rules, and approval route are agreed. |
2 — First draft | T-3 months | Department heads + Finance | Department schedules, assumptions, first consolidated P&L, and issue list. | Every material gap is logged; no unexplained plug is accepted. |
3 — Challenge | T-2 months | GM + Finance + Departments | Revised assumptions, margin and labour tests, capex and cash questions, and open-decision log. | Each material change has a source, owner, impact, downstream effect, and approval status. |
4 — Owner review | T-1 month | GM + Finance + Owner | Decision-ready pack, risks, scenarios, capex and cash approvals, and conditions. | Approved, conditionally approved, or returned for specific unresolved items. |
5 — Approved baseline | Before period | GM + Finance + Owner | Locked budget, assumption log, version register, approval conditions, and forecast-handoff calendar. | Approved file is protected and the first forecast review is scheduled. |
BEST PRACTICE
Do not ask the first draft to do the work of the final budget. Ask it to reveal the main assumptions, contradictions, missing sources, and ownership gaps while there is still time to improve them.
4. Azure City Resort — from first draft to approved baseline
Azure’s budget changes because the evidence and management decisions improve, not because someone silently overwrites the total. Each version has a purpose, a named review point, and an explicit status.
Version | Review stage | Synthetic working position | Control / decision |
|---|---|---|---|
v01 | Department first draft | 73% occupancy; $158 ADR; about $12.0m revenue; about $3.9m GOP. | Unsupported stretch; sources and operating handoffs are incomplete. |
v02 | Finance review | 70% occupancy; $153 ADR; about $11.25m revenue; about $3.45m GOP. | Sources reconcile; group wash and utility linkage are flagged. |
v03 | GM challenge | 71% occupancy; $154 ADR; $11.484m revenue; $3.579m GOP. | Management accepts the commercial logic and approximately 50.9% incremental flow-through. |
v04 | Owner review | Same operating case, subject to owner decisions. | Room-refresh capex and direct-channel marketing release remain open. |
v05 | Approved baseline | Approved numbers, assumptions, owners, conditions, and review triggers. | File is locked; first monthly rolling forecast is scheduled. |
Record why the number changed
Weak version note: “Version 3: revenue changed after management review.”
Decision-ready version note: “v03 dated 15 November: occupancy changed from 70.0% to 71.0% and ADR from $153 to $154 after the GM accepted the reconciled corporate-account base, the group pipeline after wash, and the weekend demand actions. Rooms revenue increased to $7,183,638. Owner: Revenue Manager. Reviewed by GM and Finance. Open dependency: owner approval of room-refresh capex and direct-channel marketing release.”
AI LENS
AI may compare controlled versions and return the prior value, new value, changed driver, financial impact, source, source date, assumption owner, approver, unresolved dependency, and downstream schedules affected. Undocumented changes must be marked Control exception. AI must not infer a reason that was not recorded.
Compare the approved budget baseline with the selected prior version and the current forecast using only the attached approved files.
For each material change, return:
1. prior value and new value;
2. changed operating driver;
3. financial impact;
4. source file and source date;
5. assumption owner;
6. reviewer or approver;
7. unresolved dependency or condition;
8. downstream schedules that should have changed;
9. whether those schedules were refreshed;
10. control exception and required human verification.
Do not infer or invent a reason that is not recorded. Mark undocumented reasons as “Control exception.” Do not approve assumptions or management actions.
External benchmarks may challenge the reasonableness of the story, but they do not override the reconciled source lock. Match geography, property class, segment, metric definition, reporting period, and access date before using a benchmark as a reasonableness check.
5. Build the calendar around outputs and gates
The budget calendar is the first working control document. It should not be a list of meetings. Every stage must state the output due, the person responsible, the review or approval owner, and the point after which a change requires formal approval.
Stage | Required output | Primary owner | Control point |
|---|---|---|---|
Kickoff | Calendar, responsibility matrix, owner brief, and approval route. | GM + Finance | Dates, attendees, templates, stage gates, and escalation route are confirmed. |
Environment scan | One-page summary of demand, cost, labour, contract, capex, and owner assumptions. | GM + Functional leads | Each material assumption has a source or is labelled management judgement. |
Source lock | Dated register of approved PMS, POS, payroll, P&L, pipeline, contract, and capex files. | Finance + Source owners | No undated or unidentified extract enters the first draft. |
Department build | Department schedules and supporting assumptions. | Department heads | The operating owner can explain the drivers, not only the total. |
Finance consolidation | First full model and issue list. | Finance | Formulas, mappings, classifications, and versions are checked. |
GM challenge | Revised assumptions and open-decision log. | GM | Changes are made to assumptions and handoffs, not only to totals. |
Owner review | Decision-ready pack with risks, capex, cash, and conditions. | GM + Finance | Unresolved decisions are visible, assigned, and dated. |
Final approval | Approved budget, assumptions, conditions, and version status. | Owner / authorised approver | The approved file is protected from silent editing. |
Forecast handoff | Monthly forecast calendar, trigger list, and action log. | GM + Finance | The first post-approval review is already scheduled. |
COMMON MISTAKE
A calendar that lists only meeting dates creates activity, not control. It must identify the output due at each stage and the person responsible for producing, reviewing, or approving it.
PRACTICAL NOTE
Build the calendar backward from the required approval date. Do not place source lock and department submission on the same date; departments need time to use the approved sources. Preserve a revision window between the GM challenge and owner review.

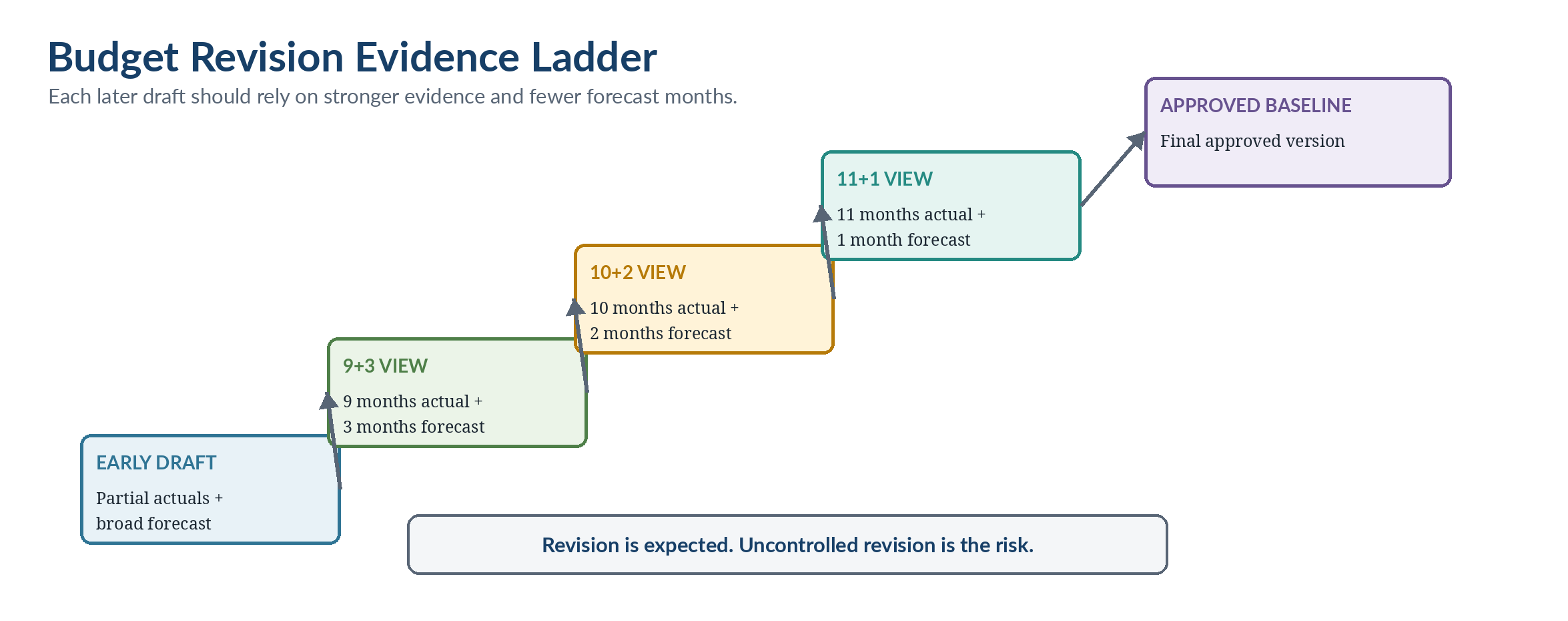

6. Strengthen the evidence before approval
A budget prepared three to four months before the period cannot rely on final current-year actuals, and it should not wait for them. The team builds an early view, then refreshes the comparison base as stronger evidence becomes available.
A 9+3 view uses nine months of actual results and three months of forecast. A 10+2 view uses ten actual months and two forecast months; an 11+1 view uses eleven actual months and one forecast month. The labels matter less than the discipline: each later pass should reduce speculation, identify what changed, record who approved it, and refresh every affected schedule.
REALITY CHECK
Later evidence does not authorise uncontrolled last-minute editing. When the team says it is “just updating the numbers,” it may actually be changing occupancy, ADR, wage rates, payroll load, food cost, utility escalation, event pipeline, capex timing, or cash assumptions. Each material change must remain visible.
Source files come before opinions
Before the first serious budget discussion, agree which source controls each data type. The meeting should not begin with a debate about which version of room nights, covers, payroll, pipeline, or accounting revenue is correct.
Source | Budget use | First control question |
|---|---|---|
PMS / CRS / RMS | Occupancy, ADR, room nights, segment, channel, cancellation, and pace. | Does the extract reconcile to accounting rooms revenue after known adjustments? |
POS | Covers, average check, outlet sales, and menu mix. | Does the extract reconcile to F&B revenue in the accounts? |
Labour roster / payroll | Hours, wage rates, payroll load, vacancies, and productivity. | Are planned hours separated from paid actuals and statutory payroll cost? |
Accounting / P&L | Actuals, budget, prior year, accruals, prepaids, and classifications. | Is the close complete, reconciled, and version-controlled? |
Sales and events pipeline | Group rooms, banquets, meetings, conversion, and wash. | Are status, probability, cut-off, and cancellation terms realistic? |
Market data | Demand, competitive set, events, inflation, and wage pressure. | Is the source current, comparable, and relevant to the budget period? |
Contract schedules | Utilities, maintenance, licences, leases, and service contracts. | Are renewal dates, minimums, escalation clauses, and termination rights included? |
Capex tracker | Project cost, timing, priority, approval, disruption, and cash requirement. | Is approval status confirmed and is the risk of delay visible? |
BEST PRACTICE
Five source-file rules: agree the controlling source for each data type; record the extract date; document every reconciliation difference; name one source owner; and never use a number from a source you cannot identify, date, or reconcile.
7. Assign ownership before modelling
Finance coordinates the model, reconciles sources, tests formulas, manages versions, and prepares the consolidated pack. Finance should not silently own rooms demand, F&B covers, staffing levels, capex priorities, or owner return expectations. Those assumptions belong with the people who understand or approve the operating reality.
Area | Input owner | Review owner | Approval owner |
|---|---|---|---|
Rooms revenue | Revenue Manager / Sales | GM + Finance | GM / Owner |
F&B and events | F&B Manager / Events Lead | GM + Finance | GM / Owner if material |
Labour | Department heads + HR | HR + Finance + GM | GM |
Department costs | Department heads | Finance + GM | GM |
Capex | Engineering + GM + Finance | Owner / Asset Manager | Owner |
Cash and funding | Finance | GM + Owner | Owner |
Final budget pack | Finance | GM | Owner / Head office |
Hotels need both top-down direction and bottom-up logic. Ownership establishes the return expectation, GOP ambition, cash constraint, capex envelope, and strategic priorities. Department heads explain the operating activity and resources required. The GM resolves the trade-offs. A target challenges the assumptions; it does not replace them.
OWNER LENS
Owners and asset managers need to know whether the targets are achievable, which risks are real, which assumptions drive the result, and what decisions remain pending. They do not need every working detail, but they do need a credible management response plan.
8. Complete the environment scan before the first draft
Every budget starts with a view of the future. That view should be informed, dated, and short enough to guide the first draft. The output is a one-page assumption summary, not a research report. Where evidence is unavailable, label the statement as management judgement and assign a review trigger.
Topic | Question before the first draft |
|---|---|
Historical pattern | What did occupancy, ADR, RevPAR, covers, average check, payroll, and major costs look like in the last two full years, and which months were unusual? |
Demand calendar | Which events, holidays, infrastructure changes, renovations, closures, access changes, or competitor openings will affect demand? |
Competitive position | Has the competitive set, pricing position, product quality, or value proposition changed? |
Channels and segments | What is changing in direct, OTA, group, corporate, wholesale, government, and other material segments? |
Labour | Are wage rates, payroll load, benefits, statutory costs, vacancies, or productivity assumptions changing, and from what date? |
Contracts and utilities | Which supplier, utility, maintenance, technology, licence, or lease commitments expire or escalate? |
F&B and supply | Are food-cost inflation, supply disruption, menu mix, outlet hours, or event assumptions changing? |
Owner and asset decisions | Which capex, renovation, brand, debt-service, distribution, funding, or asset decisions affect the budget year? |
9. Lock sources, assumptions, and versions
Three linked registers prevent the budget process from losing its memory. The source lock states which files are approved. The assumption log records the operating story behind the numbers. The version register records the file history and approval status.
Register | Required fields | Decision it protects |
|---|---|---|
Source lock | System or file; extract date; period covered; source owner; tie to accounting; known limitation. | Which evidence is approved for this draft, and what remains provisional or unreconciled? |
Assumption log | Area; assumption statement; source; owner; financial impact; status; review date or trigger. | Why is this number in the budget, who owns it, and when must it be reconsidered? |
Version register | File name; version; stage; date; main change; preparer; reviewer or approver; status; location. | Which file is current, what changed, and which version became the approved baseline? |
REALITY CHECK
A source difference is not always an error. PMS revenue, accounting revenue, and pipeline revenue may each be correct in their own context. The control issue is whether the difference is understood, labelled, reconciled, and assigned before a budget decision is made.
FILE NAMING CONVENTION
[Property]_Budget_[Year]_v[##]_[Stage]_[YYYYMMDD]
Example: Azure_Budget_2027_v03_GMChallenge_20261115
Version | Main change | Status |
|---|---|---|
v01_DeptSubmission | Initial department inputs and assumptions. | Draft |
v02_FinanceReview | Formula checks, mappings, reconciliation issues, and missing inputs. | Draft |
v03_GMChallenge | Revised revenue, labour, cost, capex, cash, and operating assumptions. | Under review |
v04_OwnerReview | Decision-ready pack with risks, conditions, and open decisions. | Submitted |
v05_Approved | Approved baseline and forecast handoff. | Approved and locked |
BEST PRACTICE
Save a new version at each material decision point, not at every small edit. Archive prior versions away from the current working file. Protect the approved baseline. Never use file names such as final, latest, revised, or v_final; they become meaningless within days.

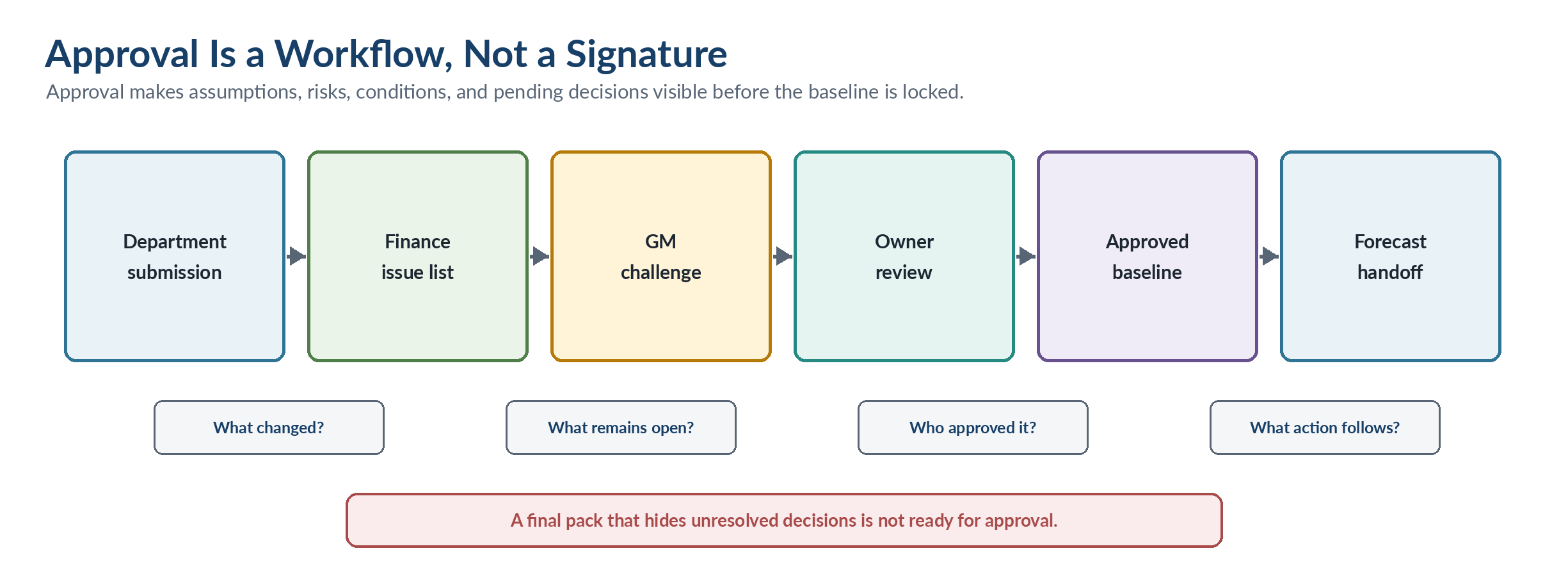

10. Approval is a workflow, not a signature
A strong approval workflow shows which assumptions were approved, which risks remain open, which conditions attach to approval, and which decisions are still pending. The final pack should not hide unresolved issues.
If a capex project awaits owner approval, say so. If the labour plan assumes recruitment that has not been confirmed, mark it. If rooms revenue depends on an unsigned group contract, show the exposure. If the event pipeline includes tentative business, risk-adjust it rather than presenting every enquiry as confirmed.
Approval-pack element | What it must show |
|---|---|
Final P&L summary | Total operating revenue, departmental profit, undistributed expenses, GOP before management fees, GOP %, and material change from prior year or latest forecast. |
Revenue assumptions | Segment, volume, price, channel, group base, event pipeline, acquisition cost, and principal risks. |
Labour assumptions | Minimum coverage, flexible staffing, productivity, vacancies, wage rates, payroll load, and recruitment dependencies. |
Key cost assumptions | Contracts, inflation, utilities, repairs, marketing, controllable costs, and costs that cannot flex quickly. |
Capex and cash timing | Project cost, approval status, disruption, cash outflow, funding requirement, and risk of delay. |
Risks and opportunities | Conditions that could move revenue, GOP, cash, service, or asset performance materially above or below plan. |
Open decisions | Items requiring owner, GM, corporate, or department decision, with owner and due date. |
Version and approval status | Exact file version, approval date, approver, conditions, and any excluded or deferred item. |
First 30-day actions | Immediate operating actions required when the budget period starts. |
OWNER LENS
The owner review should not be the first real challenge. It should be the point where a visible, tested, and decision-ready budget is approved, conditionally approved, or returned for specific unresolved items.

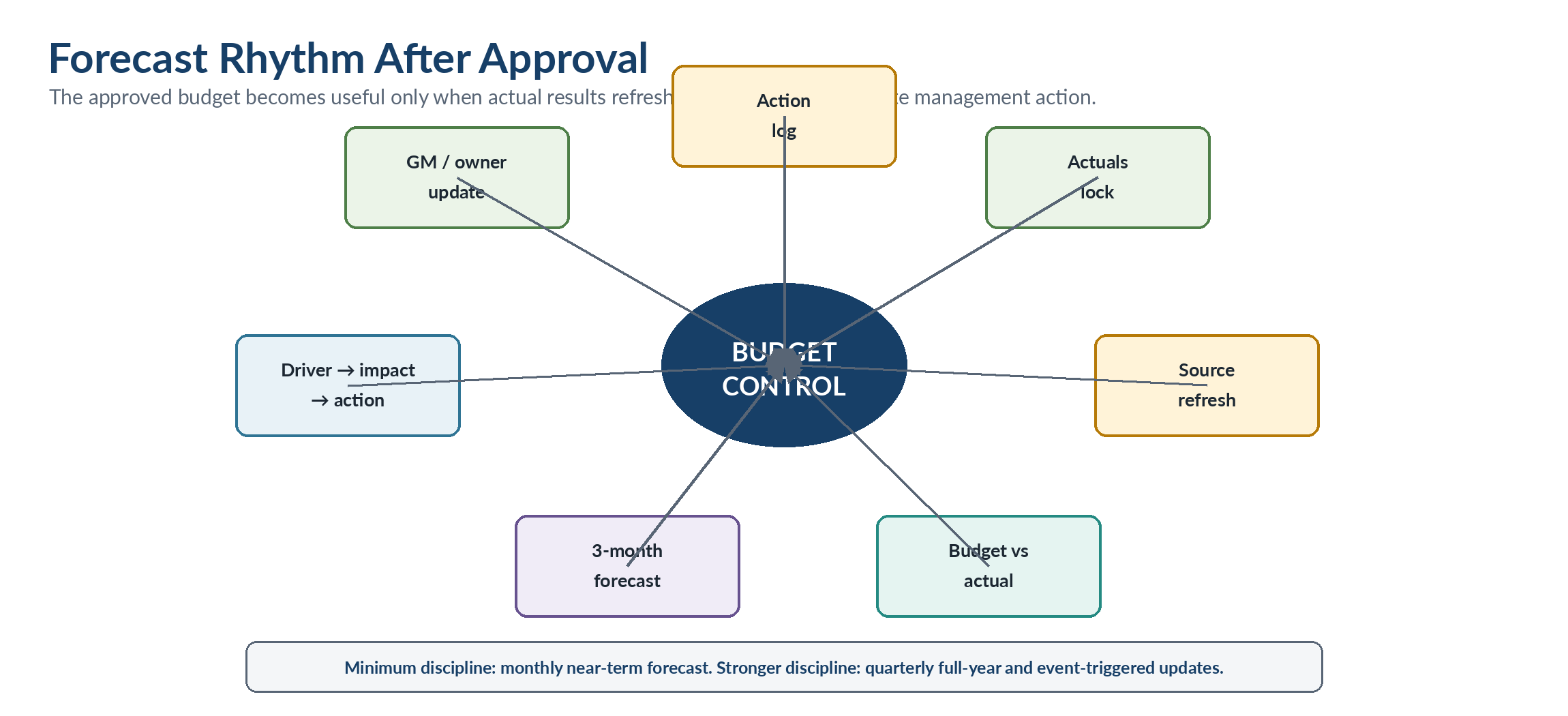

11. Hand the approved budget into forecasting
The process does not end when the annual budget is approved. The approved budget becomes the locked benchmark. The forecast is management’s latest view. Without a forecast rhythm, the budget becomes historical evidence rather than a management control.
Forecast type | Frequency | Horizon | Purpose |
|---|---|---|---|
Monthly near-term forecast | Every month after actuals close. | Normally the next three months. | Manage near-term revenue, labour, purchasing, operating cost, cash, and owner communication. |
Event-triggered reforecast | Whenever a material condition changes. | Variable. | Respond to demand shock, major group win or loss, renovation delay, cost inflation, owner decision, political risk, or disruption. |
Quarterly full-year reforecast | At least quarterly. | Full remaining year. | Test whether the hotel is still likely to achieve budget, the size of the gap, and the strategies required. |
Five questions for every forecast review
Question | Required management answer |
|---|---|
What changed? | State the fact and the period affected. |
Which driver changed? | Identify volume, price, mix, productivity, rate, contract, timing, or another operating driver. |
What is the financial impact? | Quantify revenue, departmental profit, GOP, cash, capex, or owner-level effect. |
What action follows? | State the management action, not merely the explanation. |
Who owns it and by when? | Assign one accountable owner, a due date, and the next review trigger. |
REALITY CHECK
The forecast is not a device for lowering the target every month. The budget remains the approved benchmark; the forecast is the latest management view. Every material variance should state the changed driver, financial impact, action, owner, due date, and next review trigger.
12. Common mistakes and lean scaling
Mistake | What it causes | Prevention |
|---|---|---|
Modelling before sources are agreed. | Rework because numbers change underneath the model. | Complete source lock before department build. |
Finance owns operating assumptions. | Finance becomes accountable for numbers it cannot deliver. | Assign input, review, and approval owners before modelling. |
Starting too late. | Compressed challenge, weak department logic, and rushed approval. | Begin early enough to preserve controlled review passes. |
Starting too early and treating the draft as final. | Speculative assumptions become locked too soon. | Use the early draft for orientation and refresh it with later evidence. |
Allowing uncontrolled versions. | Several files appear current and only one is correct. | Use the naming convention, version register, and archive folder. |
Owner review is the first challenge. | Material issues surface too late to rebuild properly. | Complete Finance review and GM challenge first. |
Budget is not connected to forecasting. | The approved file becomes static history. | Schedule the first forecast review before final approval. |
PRACTICAL NOTE — LEAN TOOLKIT
A smaller operation can keep the five core controls to one page each: budget calendar, responsibility matrix, source-file checklist, assumption log, and version register. The objective is not administration for its own sake; it is one clean, approved baseline that the team can explain and manage.
Reader lab — the forecast handoff that failed
Azure approved its budget promptly and locked the final version. Six weeks later, the first forecast cycle fails. Revenue is refreshed, but labour and departmental costs remain on the original volume. A major group cancellation does not trigger a reforecast because ownership is unclear. The monthly variance pack states the gap but not the driver, action, owner, or due date.
Diagnose each failure as either a missed process event or a broken control. Identify which review should have occurred—monthly, event-triggered, or quarterly—and which control should have caught the problem: calendar gate, responsibility matrix, source lock, assumption log, version register, approval condition, or forecast trigger.
Then redesign the handoff. Define the group-cancellation trigger, the source that confirms it, the person who initiates the reforecast, the schedules that must refresh, the approval or escalation route, and the management action record. The objective is not another spreadsheet. It is a reliable operating response.
Budget-process readiness check
# | Review question | Property answer / evidence |
|---|---|---|
1 | Does the process start early enough for at least two controlled challenge rounds? | |
2 | Does every stage have a required output, owner, reviewer, and exit gate? | |
3 | Are all first-draft source files dated, identified, and reconciled or clearly limited? | |
4 | Does every material assumption have an operating owner and approval status? | |
5 | Can the team identify the current working version immediately? | |
6 | Are open decisions, conditions, and dependencies visible in the owner pack? | |
7 | Is the approved baseline locked and protected from silent editing? | |
8 | Is the first monthly forecast review scheduled before the budget period begins? |
Digital companion decision
This chapter justifies a digital companion because the process involves multiple dates, source files, owners, approval states, versions, dependencies, and forecast triggers. The chapter teaches the management logic; the companion provides the linked registers and formula-driven readiness checks needed to run the process consistently.
DIGITAL COMPANION — DC-03 BUDGET PROCESS AND FORECAST HANDOFF
Included modules: process dashboard; budget calendar; responsibility matrix; source lock; environment scan; assumption log; version register; approval pack; forecast rhythm; Azure completed example; and a lean toolkit.
The workbook is a control system, not a replacement for the property’s detailed revenue, labour, capex, or cash models. Those calculations remain in their technical chapters.
Chapter close
This chapter established the workflow that makes a hotel budget reliable before the technical schedules are built. The process moves through timing, evidence, ownership, source control, revision, approval, and forecast handoff. The central control is deliberate revision: start early enough to research, use stronger evidence before approval, record why material assumptions changed, and carry the approved baseline into monthly management action.
Action register
This week: map the calendar, complete the environment scan, lock the first sources, assign owners, and schedule the first forecast review.
Action | Owner | Source / tool | Target date | Status / notes |
|---|---|---|---|---|
Map the current calendar against the five-pass process. | DC-03 / Calendar | |||
Complete the environment scan with operating leaders. | DC-03 / Environment Scan | |||
Build the responsibility matrix and source lock. | DC-03 / Owners + Sources | |||
Create the assumption log and version register. | DC-03 / Registers | |||
Schedule the first forecast review and define event triggers. | DC-03 / Forecast Handoff | |||
Next: Chapter 4 applies these controls to rooms market research and revenue strategy, beginning with the evidence and commercial choices required before the rooms revenue model is built. | ||||
Source note: Azure City Resort and all numerical illustrations are synthetic. Calendar, source-lock, version, approval, and forecast controls should be adapted to the property’s reporting year and governance structure.
Forward handoff to the integrated rolling forecast
This chapter establishes the approved baseline, forecast calendar, source locks, version discipline, monthly review, event-triggered update and quarterly full-year view. It does not build the technical forecast model. Chapter 27 imports the standardized driver handoffs from Chapters 4–23 and consolidates the complete rolling P&L, cash and balance-sheet forecast while preserving the locked budget baseline.
FORECAST BOUNDARY
Use Chapter 3 to govern when, why and by whom a forecast is refreshed. Use Chapter 27 to calculate and consolidate the hotel-wide forecast.
Digital companion
Practice and apply this chapter
Open the working resource associated with this section. Access follows the resource setting shown on each card.
Excel workbook / working template
DC-03 Budget Process Architecture
When to Start, Who Owns What, and How the Budget Becomes a Forecast
DC-03_Budget_Process_and_Forecast_Handoff_v1.0_Sample_Filled.xlsx · download readyExcel workbook
DC-03 Budget Process and Forecast Handoff
Convert the approved budget architecture into a controlled annual process covering the calendar, responsibilities, source locks, assumptions, versions, approvals, and forecast rhythm.
DC-03_Budget_Process_and_Forecast_Handoff_v1.0_Sample_Filled.xlsx · download readyChapter-end learning
Apply, check, and remember
Apply it to your situation
Connect the chapter to a real hotel decision
As you answer, think about where this issue appears in your own property, team, report, meeting, or control process. Work through one item at a time, check the result, and then continue.
You can complete the learning tools now. Sign in to save quiz attempts and flashcard confidence.
Knowledge check
Question 1 of 6
Memory practice
Flashcard 1 of 10
Reveal the answer, decide how confident you are, and then move to the next card.
Continue the discussion
Share how this applies in practice
Use the chapter’s calendar, responsibility matrix, source lock, assumption log, version register, approval conditions, and forecast triggers.
Your hotel has approved its annual budget, but the first forecast cycle fails: revenue is refreshed, labour and departmental costs are not, a major group cancellation does not trigger a reforecast, and the variance pack contains explanations without actions. How would you redesign the process handoff?
Identify each missed review or control, assign an accountable owner, define the event trigger, list the schedules that must refresh, preserve the approved baseline, and state the action record required after the reforecast.
Sign in to contribute to this discussion.
0 responses
Responses are public and may be moderated to keep the exchange professional and useful.
No responses yet. Start the discussion with a practical example or a question raised by the chapter.
Reading progress
Finished this chapter?
Sign in to save your place and track which chapters you have finished.
