Chapter 2Hotel Budget Architecture
Map how market evidence, revenue, operating activity, departmental cost, labour, GOP, capex, cash, forecasting, and owner decisions connect before detailed schedules are built.
Questions this chapter helps answer
- How should a hotel budget connect revenue, departmental costs, labor, qualitative priorities, consolidation, capex, cash, and owner decisions?
- What handoffs are required when a material hotel budget assumption changes during review?
- Why should managers change named assumptions and drivers rather than simply overwriting a consolidated budget total?
Key concepts
- budget architecture
- revenue budget
- departmental cost budget
- labor and productivity
- qualitative priorities
- financial consolidation
- capex
- cash flow
- assumption handoff
How the budget is built, connected, reviewed, and used
This chapter builds the map of the hotel budget before detailed schedules are prepared. It shows what comes first, where the revision loop sits, and how a change in revenue, cost, labour, capital expenditure, or cash moves through the rest of the plan.
EXECUTIVE TAKEAWAY
A hotel budget is not one number and not one spreadsheet. It is a connected architecture of assumptions, operating plans, financial outputs, capital decisions, cash timing, and owner communication. Each material part needs a source, a driver, an owner, a check, and a clear handoff to the next layer.
Learning outcomes
• Distinguish a budget file from a controlled budget architecture.
• Map the architecture components in the order in which they are built and reviewed.
• Identify each layer’s main drivers, owners, limitations, and required handoff.
• Trace a material change across operating activity, departmental cost, labour, GOP, cash, and owner decisions.
• Use source, version, folder, and AI discipline without allowing tools to replace management judgment.
New in this chapter: budget architecture, operational budget, financial budget, and interdependence. Standing terms, including gross operating profit (GOP), are defined in the Master Glossary.
BOUNDARY NOTE
This chapter is the map, not the engineering drawings. It does not calculate the correct average daily rate, labour ratio, food-cost percentage, or capital priority. Those decisions are developed in the technical chapters. Here, the reader learns where each decision lives and how it connects.

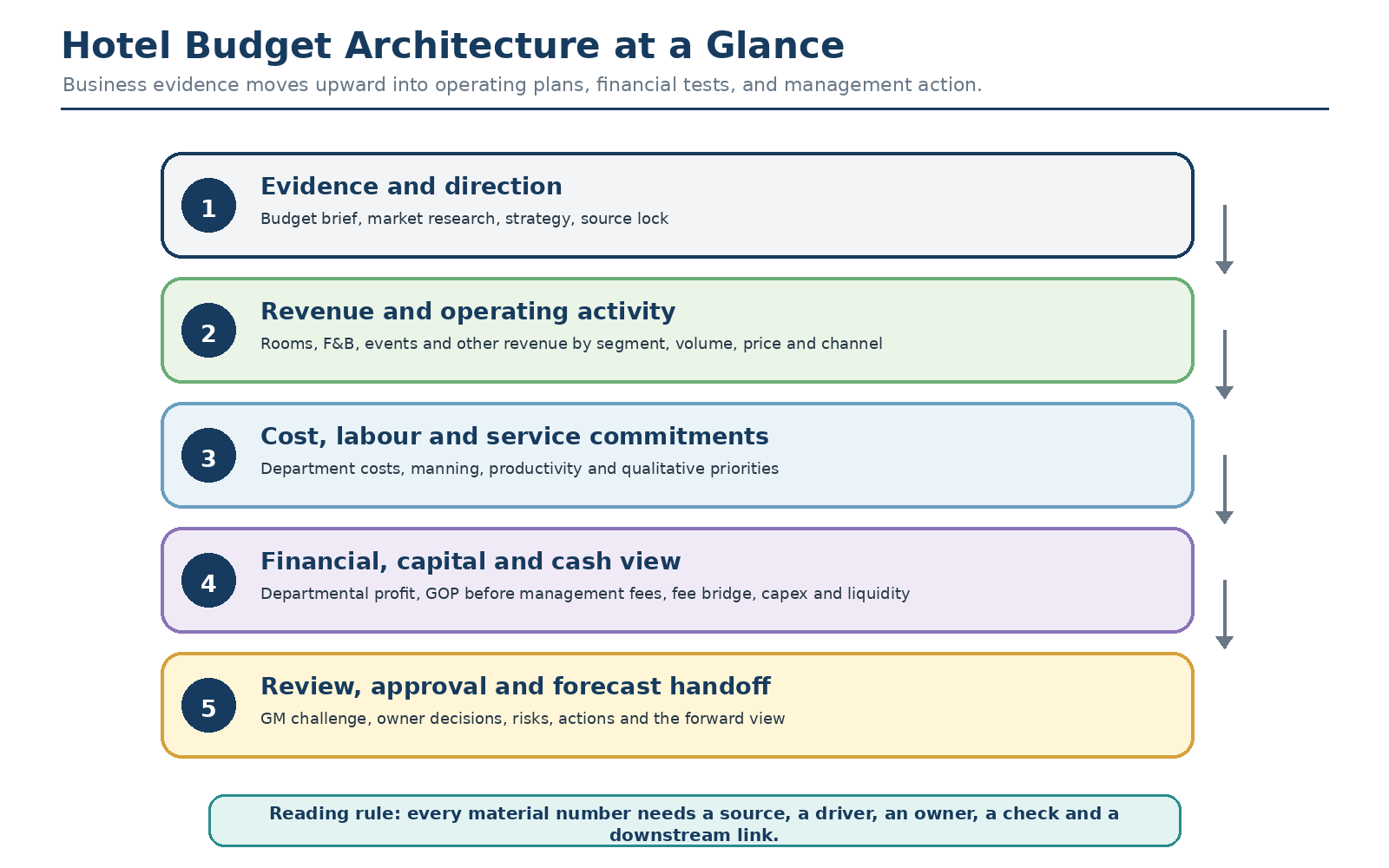

1. What “budget architecture” means
A budget often begins by opening last year’s workbook and adding tabs until the file feels complete. Size is not architecture. Architecture means the major parts are arranged in a deliberate order, each part has a management purpose, and each part connects to a downstream operating or financial consequence. It answers one practical question: how does the hotel’s strategy become revenue, cost, labour, service, profit, cash, and owner action?
Thinking architecturally stops review from beginning and ending with account lines. It makes assumptions visible before approval, clarifies ownership, and exposes contradictions early: revenue growth without sufficient capacity, delayed capital expenditure without maintenance risk, or cost reduction without service impact.
COMMON MISTAKE
Do not confuse a clean architecture with a correct budget. The structure can be well designed while the assumptions inside it remain weak, outdated, unreconciled, or commercially unrealistic.
2. Operational budget and financial budget
Teams often treat the budget as a purely financial plan. In practice, a credible budget combines an operating plan with its financial consequences.
The operational budget explains what the hotel plans to do: rooms sold, covers, event volumes, staffing, supplies, service standards, repairs, campaigns, and operating days.
The financial budget converts those choices into money: departmental revenue, departmental profit, undistributed expenses, GOP before management fees, the management-fee bridge, fixed charges, cash flow, and owner-level results.
Question | Operational budget | Financial budget |
|---|---|---|
What does it explain? | What the hotel plans to do. | What those choices mean in money. |
Typical language | Rooms sold, covers, events, staffing, contracts, repairs, campaigns, service standards. | Revenue, expenses, departmental profit, GOP, fees, fixed charges, cash, and funding. |
Primary owners | GM, revenue leaders, department heads, HR, and engineering. | Finance lead, GM, owner, or corporate finance. |
Main risk if weak | The target can appear financially attractive but be operationally impossible. | The operating plan can be realistic but unaffordable, poorly funded, or poorly explained. |
REALITY CHECK
The operating plan creates the financial result; the financial target challenges the operating plan. A strong budget process makes the two speak to each other until both are credible.
3. Azure City Resort — building the architecture before the model
Azure’s team agrees on an ambition to grow total operating revenue to approximately $11.484 million and GOP before management fees to $3.579 million. Finance does not accept the target until the architecture shows how the demand evidence becomes monthly revenue, operating activity, departmental cost, labour, profit, cash, and owner decisions.
Architecture layer | Azure source or assumption | Primary owner | Required handoff |
|---|---|---|---|
Market and demand | Dated demand calendar; reconciled PMS history; signed corporate production; group pipeline after wash. | Revenue Manager | Monthly room nights and ADR by segment and channel. |

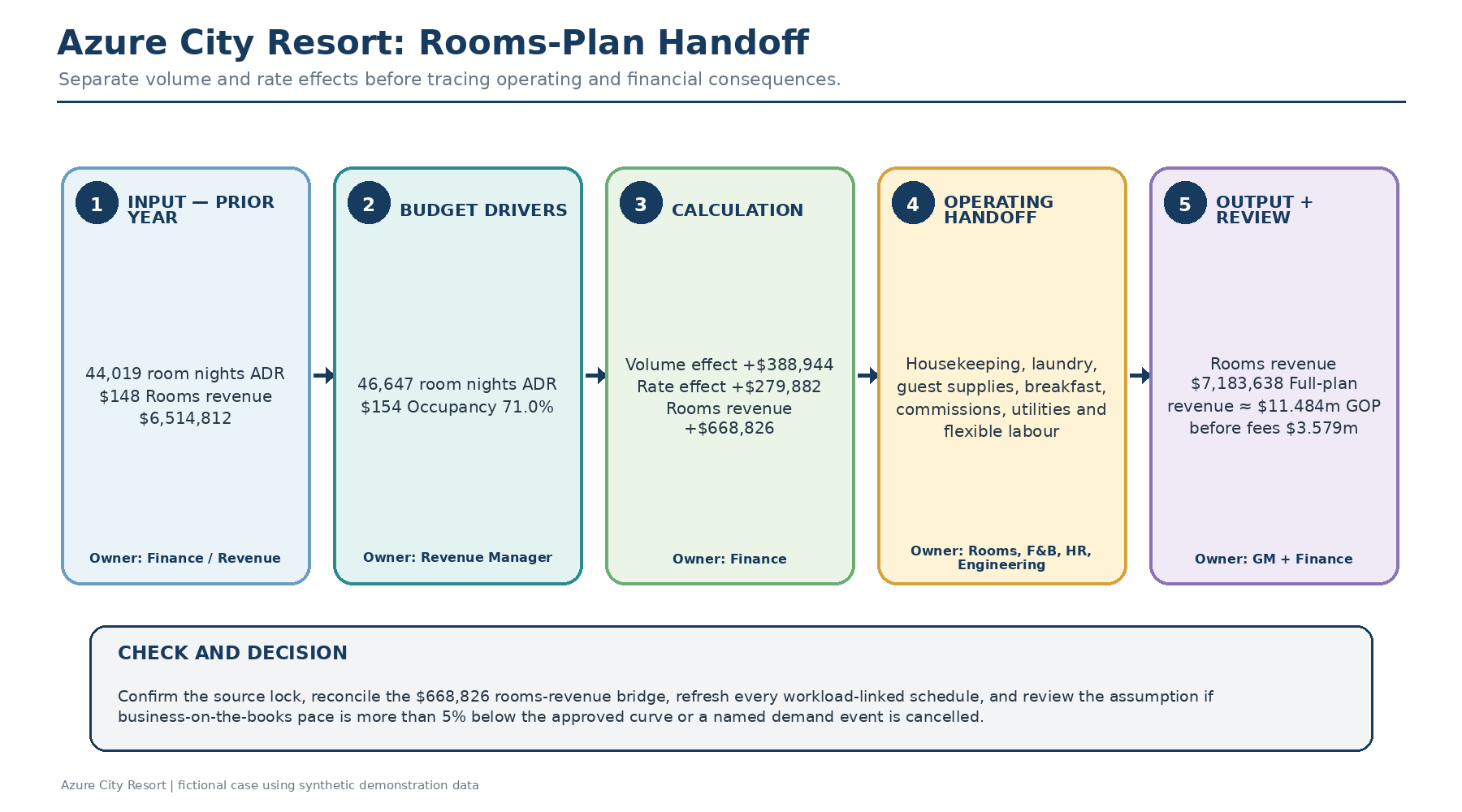

Rooms revenue | 46,647 room nights at $154 ADR; $7,183,638. | Revenue + Rooms | Occupied rooms, stayovers and departures, breakfast participation, commissions. |
F&B and other operated revenue | $3.520m F&B; $0.780m other operated revenue. | F&B, Events, Spa | Covers, events, average checks, visits, operating days. |
Department cost and labour | Workload-linked supplies, payroll, contracts, and service standards. | Department heads + HR | Departmental profit and productivity schedules. |
Undistributed expenses | $3.250m synthetic budget. | Finance + support leaders | GOP bridge and contract, utility, marketing, and support decisions. |
GOP before management fees | $3.579m / 31.2%; increase of about $509k. | GM + Finance | Fee bridge, cash, capex, risks, and owner decisions. |
Write the handoff, not only the target. The weak instruction is “raise occupancy by four points and keep costs under control.” The decision-ready assumption states the evidence, drivers, calculation, owners, consequences, and review trigger: occupancy rises from 67.0% to 71.0%, room nights rise by 2,628, ADR rises from $148 to $154, and rooms revenue increases by $668,826. Rooms, F&B, Engineering, HR, and Finance must refresh the linked schedules. Review is triggered if business-on-the-books pace is more than 5% below the approved curve or a named demand event is cancelled.
External benchmarks may test plausibility, but they do not set Azure’s local target. Use external benchmarks only as reasonableness checks. Before relying on one, match its geography, property type and class, segment, metric definition or denominator, reporting period, and access date; then explain why it is relevant to this hotel rather than copying it in as the local target.
4. The build cycle

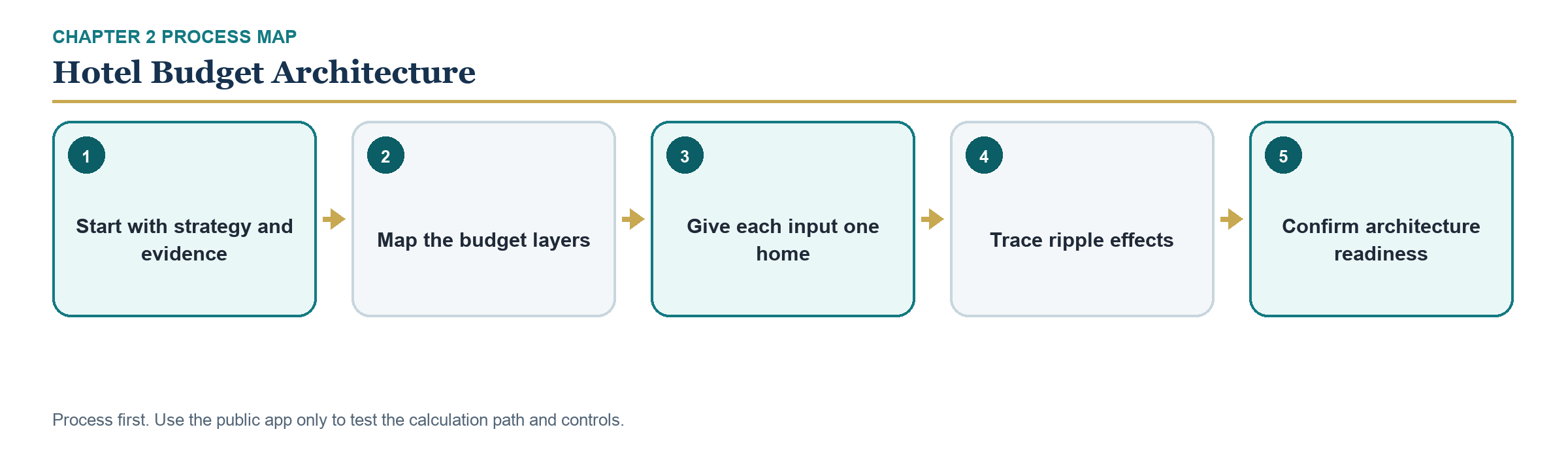

The architecture is built in sequence but tested through revision. Management starts with the brief, evidence, and revenue logic; tests the departmental cost, labour, and qualitative commitments required to deliver the plan; consolidates the financial result; challenges the assumptions; and then completes the capital, cash, owner, and forecast handoff.

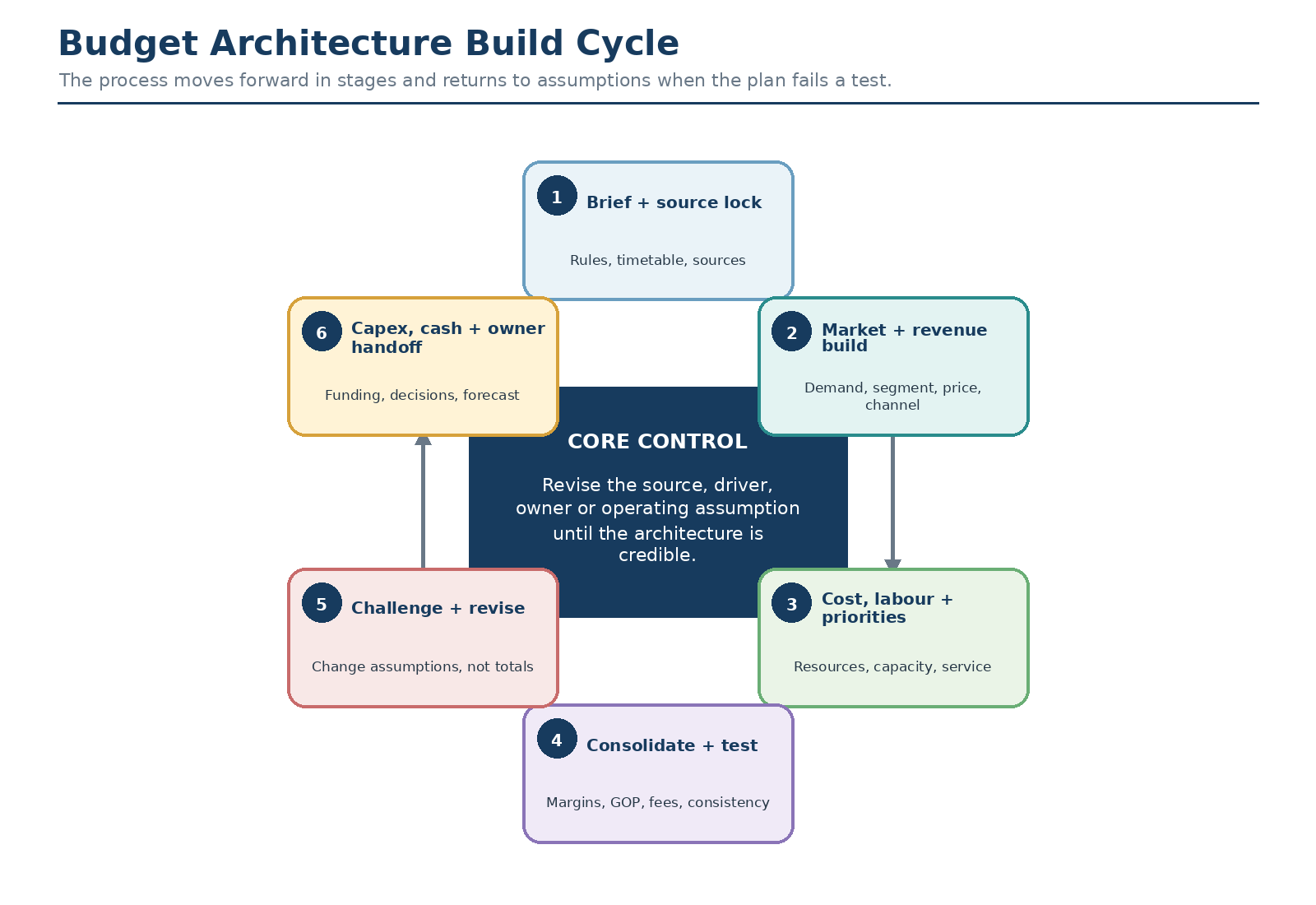

The working sequence is: (0) budget brief and rules of the game; (1) market research and business context; (2) revenue budget; (3) departmental cost budgets; (4) labour manning and productivity; (5) qualitative priorities and key performance indicators; (6) financial consolidation; (7) review, challenge, and revision; (8) capex, cash flow, and forward forecast; and (9) management review and owner summary.
Each stage affects the others. Budgets are rarely prepared in a perfectly linear sequence; review creates push and pull across the architecture. A change in one stage may require the team to reopen an earlier source, driver, workload, cost, capacity, capital, or cash assumption.
BEST PRACTICE
When a review changes a number, record which assumption changed: segment, channel, volume, price, event probability, workload, rate, contract, timing, or service standard. Do not overwrite only the total.
5. The eight architecture components — one map, eight homes
The architecture contains eight core operating and financial components, supported by the market evidence that precedes them. This chapter states each component’s job, main drivers, owner, and detailed home. It does not rebuild the technical schedules. A smaller property may combine components, while a complex hotel may subdivide them, but the control questions remain the same.
# / Component | What it must do | Main drivers | Primary owner | Chapter Map in the book |
|---|---|---|---|---|
1. Revenue budget | Turn market evidence and strategy into revenue by segment, volume, price, and channel. | Demand, occupancy, ADR, RevPAR, segment/channel mix, covers, average check, event pipeline. | Revenue, F&B, Events | Ch. 4–9 |
2. Departmental cost budget | Explain the resources required to deliver the activity plan and show what can and cannot flex. | Occupied rooms, covers, events, open days, operating hours, consumption units. | Department heads | Ch. 11, 15–20 |
3. Labour manning and productivity | Separate minimum coverage from flexible staffing and link capacity to workload. | Workload, service standards, wage rates, payroll load, productivity thresholds. | HR + department heads | Ch. 13–14 |
4. Qualitative priorities | Convert guest, people, brand, and service priorities into costed, owned, KPI-linked actions. | Strategy, guest experience, training, service standards, stakeholder commitments. | GM + department heads | Ch. 10 |
5. Financial consolidation | Bring revenue, departmental costs, labour, and undistributed expenses into the P&L, GOP before fees, and a separate fee bridge. | Classification, formula logic, schedule links, approved versions. | Finance | Ch. 17, 21–22 |
6. Capex budget | Connect asset investment to safety, compliance, property condition, guest impact, and strategy. | Project need, cost, timing, disruption, approval, risk of delay. | Engineering / GM / owner | Ch. 23 |
7. Cash flow and forward forecast | Test whether the plan can be funded, when pressure appears, and how assumptions change after approval. | Collections, payments, seasonality, working capital, debt, capex timing. | Finance | Ch. 22–24 |
8. Management review and owner summary | Translate the tested architecture into assumptions, risks, KPIs, decisions, and forecast actions. | Clarity and consistency of all prior layers. | GM + Finance | Ch. 24 |
The technical chapters apply these controls through department-specific calculations and examples.
Use the following model-building controls when detailed schedules are prepared:
• separate source inputs from calculations;
• build monthly before annual;
• build from operating drivers or segments before blended totals;
• show gross, net, and margin;
• risk-adjust uncertain pipeline;
• keep scenarios and owner-pack outputs separate from the approved base; and
• record each material override with its reason, owner, date, and approval status.
Test four cases through the same driver logic: the approved base case, a credible downside, a credible upside, and an owner-challenge case.
Change named drivers rather than overwriting totals, keep the base case locked, and state the financial effect, action, owner, and trigger for each case.
Classify each cost by how it behaves before choosing the formula: fixed, flexible with an activity driver, semi-fixed or step-based at a threshold, contract-driven, or timing-related.
State the driver and threshold where relevant, and assess management influence separately from cost behaviour.
These rules also provide guardrails for AI-assisted model drafting: preserve source separation, named drivers, locked base cases, explicit overrides, and human approval.
6. How the architecture is interconnected

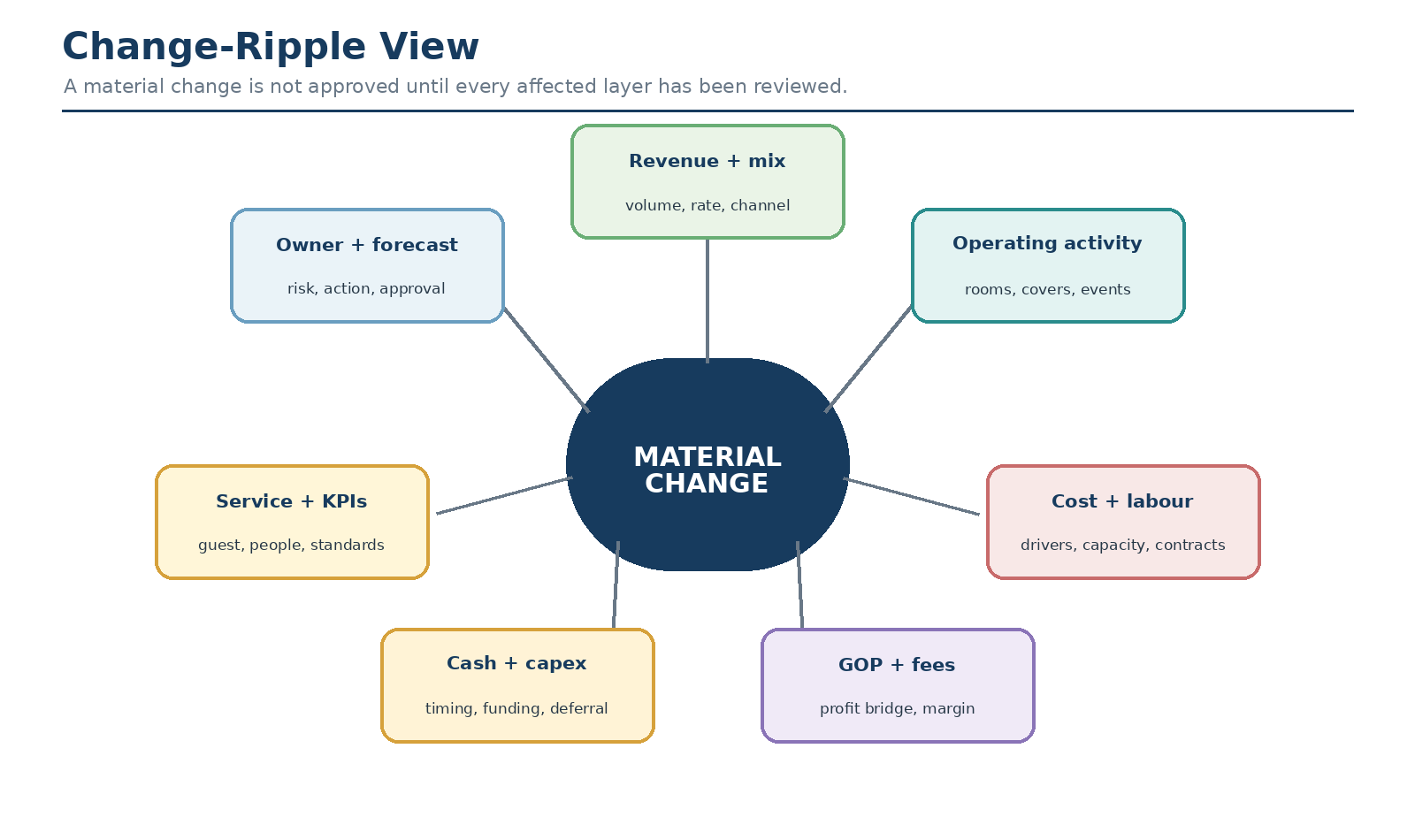

Interdependence is the main architecture discipline. A material change is rarely isolated; it can create volume, cost, labour, service, liquidity, capital, or owner-expectation pressure elsewhere. Trace the change across the system before approval.
Change | First impact | Other layers to review |
|---|---|---|
Occupancy increases | Rooms revenue and operating activity rise. | Housekeeping labour, guest supplies, laundry, breakfast, utilities, maintenance, GOP, and cash. |
ADR is protected by dropping low-rated business | Mix improves; volume may fall. | Marketing, channel strategy, staffing, forecast, and owner expectations. |
A large event is confirmed | F&B and banquet activity rise. | Food and beverage cost, event labour, purchasing, cash timing, and guest experience. |
Training is cut | Short-term cost falls. | Service quality, capability, satisfaction, turnover, and future revenue quality. |
Capex is delayed | Cash is protected now. | Maintenance cost, complaints, safety, brand compliance, and future revenue. |
Owner asks for higher GOP | The financial target rises. | Revenue assumptions, staffing, cost behaviour, capex timing, qualitative spend, and cash. |
REALITY CHECK
Before approving a major revision, ask: which assumption changed, which layers are affected, who owns each handoff, what check confirms the change reached every schedule, and what action follows if the assumption fails?
7. Responsibilities: finance coordinates, operators own
The architecture works only when responsibility is explicit. Finance coordinates the model, reconciles sources, manages versions, and tests consistency. Finance does not own every assumption. Revenue leaders own demand and pricing logic; department heads own operating resources; HR and department heads own staffing logic; Engineering and ownership own capital logic; and the GM owns the operating coherence of the full plan. The table below separates each role’s responsibility from the explanation that management must be able to provide.
Role | Owns | Must explain | Main risk if unclear |
|---|---|---|---|
Owner / Asset Manager | Return expectations, capex direction, owner-level priorities. | What result is required and why. | Targets are demanded without an operating bridge. |
General Manager | Total budget coherence and feasibility. | How strategy, revenue, service, cost, people, and cash fit together. | Departments submit silo budgets. |
Finance Lead | Model, consolidation, source and version control, reporting. | How the numbers reconcile and which assumptions drive them. | Finance becomes owner of assumptions it cannot control. |
Revenue / Sales | Demand, segment mix, channel plan, pricing, group base. | Where business comes from and at what quality. | Revenue growth is accepted without margin logic. |
Department Heads | Departmental cost, service delivery, operating actions. | What resources are required and why. | Cost is cut without workload or service logic. |
HR / People | Manning, recruitment, training, payroll inputs, productivity support. | How labour supports service and productivity. | Payroll is reviewed as a total rather than capacity. |
Engineering | Maintenance need, capex support, asset risk. | What happens if repair or capex is delayed. | Capex becomes a wish list or is cut without a risk view. |
8. Discipline that keeps the architecture usable
Three disciplines keep the architecture usable and make it possible to reconstruct the approved logic six months later:
Source and version control. Every meaningful milestone—department submission, finance consolidation, GM challenge, resubmission, owner pack, and approval—uses a dated source set and a named version.

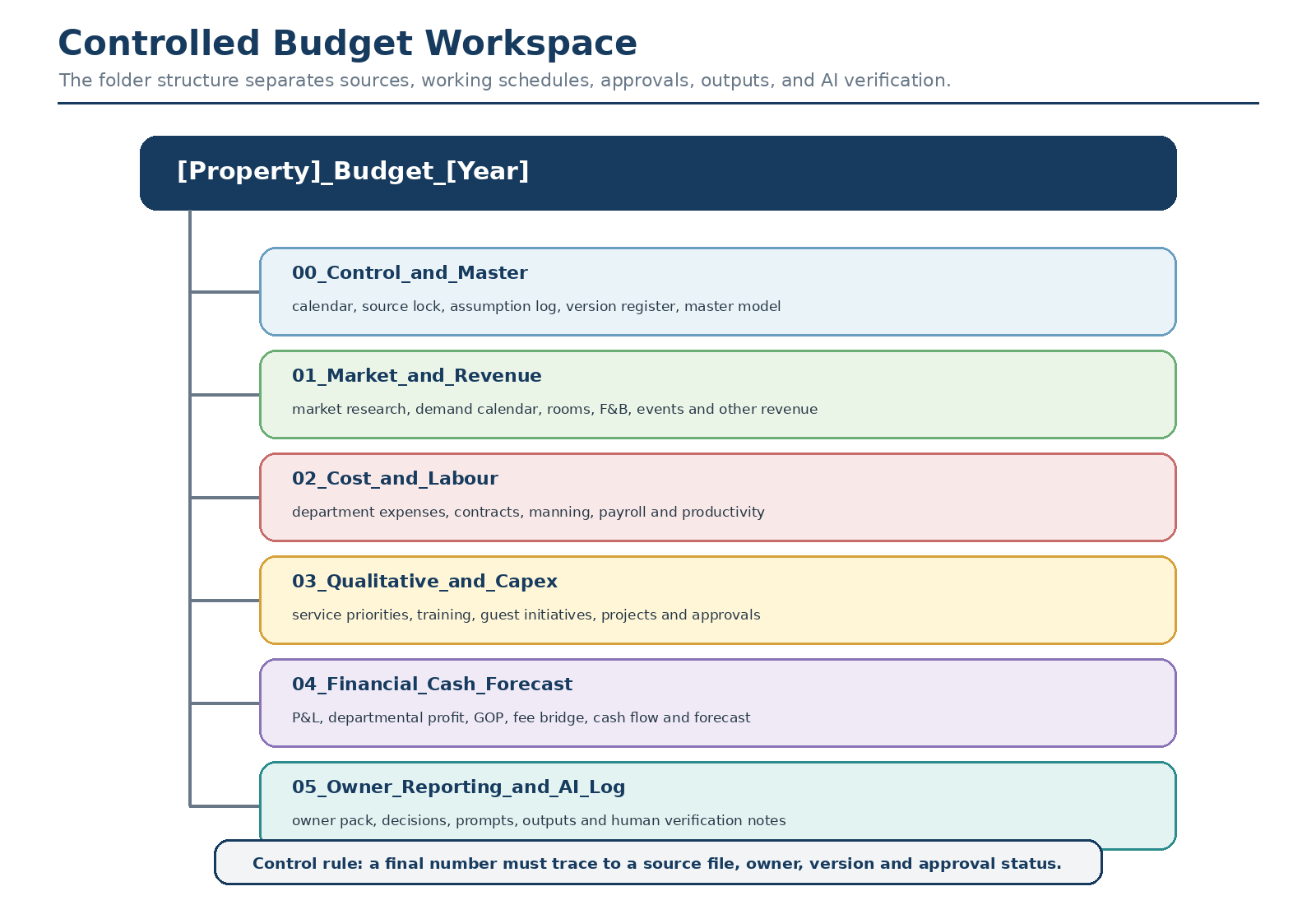

Folder structure. Separate source files, assumptions, working schedules, financial outputs, owner reporting, and AI verification notes. The structure is a management control because it preserves the path from evidence to approval.
BEST PRACTICE
Treat the folder structure as a control, not administration. If a material number cannot be traced to its source folder, source file, owner, version, and approval status, it is not ready for final review.
AI LENS
Chapter-specific task: trace each material assumption through the architecture and flag broken handoffs.
Approved inputs: the source-to-driver register, assumption log, department schedules, version register, and P&L consolidation.
Expected output: input → downstream schedule → expected linkage → observed linkage → gap → owner → management question.
Human control: use approved tools and appropriately protected data, verify every output against its source, and keep source validation, assumptions, approvals, and management decisions with named people.
PUBLIC APP COMPANION — PROCESS CHECK
Open: https://budget-app-hotel.vercel.app → Explore sample → Overview & workflow.
Try: follow the visible Revenue → Labour → Expenses → P&L dependency order.
Observe: identify which module owns each input and which outputs consume it.
Control: a repeated number should have one owning module and a visible downstream destination.
Use sample data only. The public demonstration is shared with other visitors and may be reset. Do not enter confidential hotel information. The app demonstrates the calculation path; this chapter teaches the process, evidence, judgment, and management decision.
Reader lab — the handoff that never arrived
Azure’s budget architecture is approved: each of the eight components has one defined home and one accountable owner. Then reality tests the system. The revenue team finalises the rooms plan but never formally hands the channel-cost assumption to Sales and Marketing, so commission is budgeted in two places. The F&B team builds covers from an occupancy figure that Rooms revised after F&B had locked its schedule. The capex list remains inside the operating budget with no owner-decision flag. The architecture is sound; the handoffs between components have failed. The completed Azure example in the digital companion shows the intended control path.
Diagnose each break against the eight-component map. For every failure, name the two components involved, the single field that should have crossed between them (a source, driver, owner, version, or downstream link), and the check that would have caught the gap before consolidation. Decide whether the failure sits in the architecture itself or in the discipline used to run it. Then select the single control—a source lock, version register, or owner sign-off gate—that would prevent the greatest number of failures. Finally, draw the corrected Rooms-to-F&B handoff so the covers build cannot use a superseded occupancy figure.
9. Architecture readiness check
Before detailed schedule work begins, test whether the architecture is strong enough. The objective is not perfection. It is to find missing evidence, ownership, and linkages before the model becomes too large to challenge efficiently.
Architecture question | What it tests |
|---|---|
Was market research completed before revenue targets were finalised? | Revenue has an evidence base. |
Is revenue built by segment, volume, price, and channel? | Revenue is not last year plus a percentage. |
Do departmental costs respond logically to the activity plan? | The operating budget can support the revenue plan. |
Is labour separated into minimum coverage, flexible staffing, and productivity-linked logic? | Payroll is treated as capacity, not only cost. |
Are qualitative priorities converted into actions, costs, owners, and KPIs? | Strategic intentions are budgetable. |
Does consolidation show departmental profit, GOP, the fee bridge, fixed charges, cash, and owner-level implications? | The budget is financially interpretable. |
Is there a documented revision loop? | Changes are made to assumptions, not only totals. |
Do capex and cash sit beside the P&L? | Profit is not confused with liquidity or asset need. |
Can every material number be traced to source, driver, owner, version, and downstream schedule? | The architecture is controllable. |
Is AI used only for support and review? | Tool use remains governed by human judgment. |
Chapter close
The hotel budget architecture connects market evidence, revenue strategy, departmental cost, labour, qualitative commitments, financial consolidation, capex, cash, forecast, and owner review. Each component answers a different management question; together they show how the hotel expects to operate and why the financial result is credible.
The architecture is built in sequence but tested through revision. Market evidence shapes revenue. Revenue creates workload. Workload creates cost and capacity requirements. Those decisions affect departmental profit, GOP, cash, capital need, service, and owner expectations. The discipline is simple: every material number needs a source, a driver, an owner, a check, a version, and a downstream link.
Monday actions
• Draw your property’s architecture stack and mark which layers are well defined, weak, or missing.
• Choose one material revenue assumption and trace it through activity, cost, labour, GOP, cash, and owner reporting.
• Create the first source-to-driver register with the source, extract date, driver, owner, refresh rule, and downstream schedule.
Action register
Action | Owner | Source / tool | Target date | Status / notes |
|---|---|---|---|---|
Map the full budget architecture. | DC-02 / Tab 02 | |||
Build the source-to-driver register. | DC-02 / Tab 03 | |||
Assign input, review, and approval owners. | DC-02 / Tab 04 | |||
Trace one material change through every affected layer. | DC-02 / Tab 05 | |||
Complete the architecture readiness check. | DC-02 / Tab 08 |
DIGITAL COMPANION — DC-02 BUDGET ARCHITECTURE AND HANDOFF
Purpose: map the connected budget layers, document source-to-driver relationships, assign ownership, test ripple effects, and decide whether the architecture is ready for detailed schedules.
Workbook tabs: 01_Instructions; 02_Architecture_Map; 03_Source_to_Driver_Register; 04_Component_Owner_Map; 05_Ripple_Check; 06_Folder_and_Version_Control; 07_AI_Review_Log; 08_Architecture_Readiness; 09_Owner_Summary_Skeleton; 10_Azure_Completed_Example.
Outputs: connected architecture map, source and ownership exceptions, broken-handoff log, ripple review, readiness decision, controlled workspace structure, and an owner-summary skeleton. The workbook includes a completed Azure City Resort example and a blank property version.
Chapter 3 turns this map into a controlled budget process: calendar, source lock, ownership, revision, approval, version control, and forecast handoff.
Source note: Azure City Resort and all numerical illustrations are synthetic. The architecture and ownership examples should be adapted to the property’s operating model, management agreement, and approval authority.
Digital companion
Practice and apply this chapter
Open the working resource associated with this section. Access follows the resource setting shown on each card.
Excel workbook
DC-02 Budget Architecture and Handoff
Map the connected budget layers, source-to-driver relationships, ownership, ripple effects, and architecture readiness before detailed schedules are built.
DC-02_Budget_Architecture_and_Handoff_v1.1.xlsx · download readyChapter-end learning
Apply, check, and remember
Apply it to your situation
Connect the chapter to a real hotel decision
As you answer, think about where this issue appears in your own property, team, report, meeting, or control process. Work through one item at a time, check the result, and then continue.
You can complete the learning tools now. Sign in to save quiz attempts and flashcard confidence.
Knowledge check
Question 1 of 6
Memory practice
Flashcard 1 of 10
Reveal the answer, decide how confident you are, and then move to the next card.
Continue the discussion
Share how this applies in practice
Use the chapter’s architecture map, source-to-driver register, version control, ownership map, and ripple check.
Azure’s architecture is complete, but the rooms plan reaches F&B after F&B has locked its covers schedule, channel commission appears in two components, and the capex list has no owner-decision flag. Which control failure should management correct first, and why?
Identify the components involved, the single field or version that failed to cross the handoff, the check that should have detected it, the accountable owner, and the control that would prevent the greatest number of repeat failures.
Sign in to contribute to this discussion.
0 responses
Responses are public and may be moderated to keep the exchange professional and useful.
No responses yet. Start the discussion with a practical example or a question raised by the chapter.
